David's Astronomy Pages
Notes - Session 1370 (2025-10-27)

Bullet Session Aims & Highlights
 - Observing Result
 - Night Summary Plot
 - Session Event Log
Bullet Operational Issues
- Critical Issues (0),  Major Issues (0),  Minor Issues (1),  Small Defects (0),  Continuous Improvement (0)
- Figures (1)

Bullet Images from 2025-10-27  >>

2025-10-28
Bullet AllSky/Weather Computer - Upgrade to Windows 11

Session Aims & Highlights (2025-10-27)

Main aims

  1. Targets.  Acquire images of a selection of variable stars, nearby stars, comets & deep sky targets as allowed by sky conditions.
  2. C/2025 A6 (Lemmon). Acquire images of comet C/2025 A6 (Lemmon)
  3. Dome. Check that a fix to increase the tension of the dome rotation sensor wheel has successfully resolved earlier dome azimuth/dome parking issues.

 Equipment & Software

Highlights

Notes

Summary Plots & Logs

Observing Plan

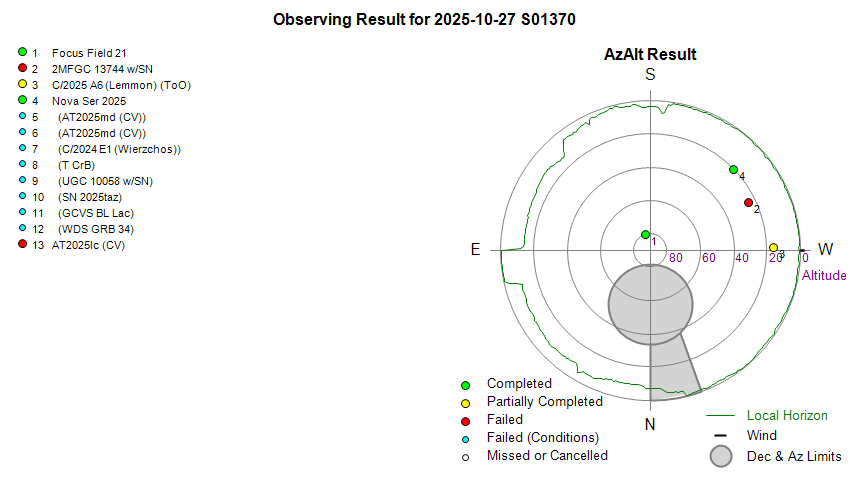

Observing Result

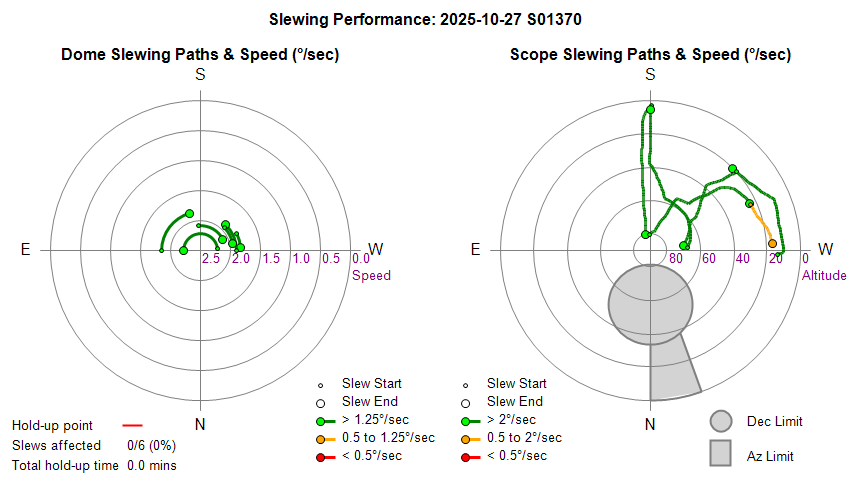

Dome & Scope Slewing Performance

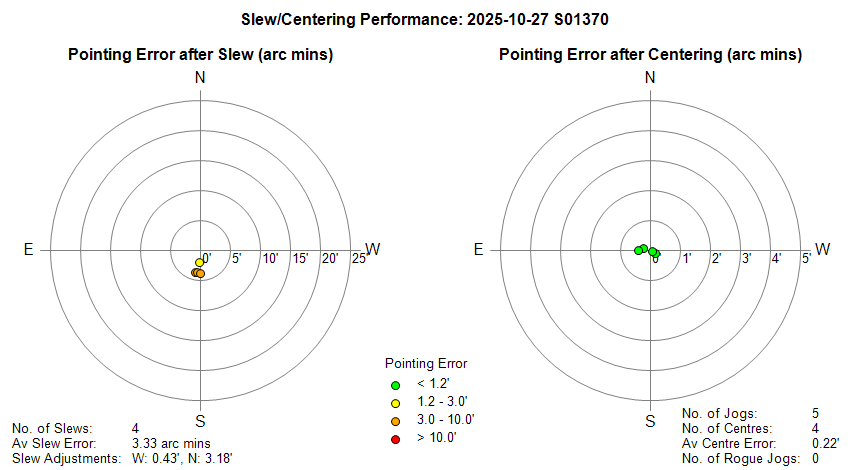

Slew/Centering Performance

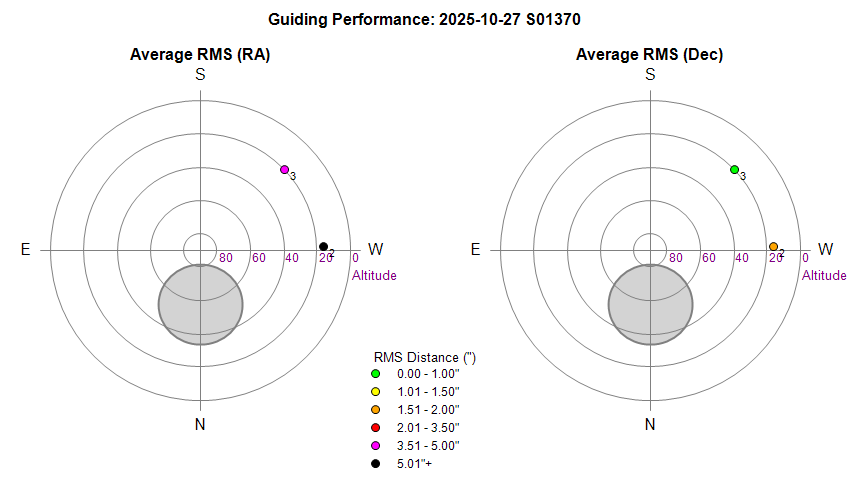

Guiding Performance

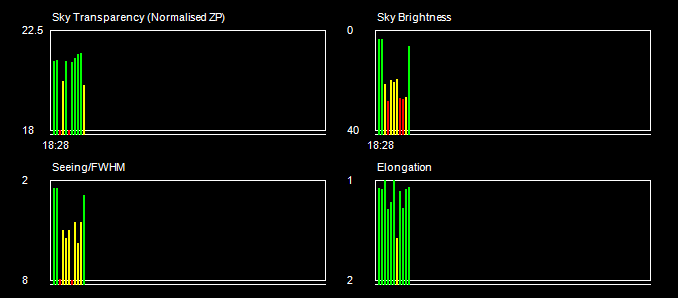

Sky Conditions (Locate Frames)

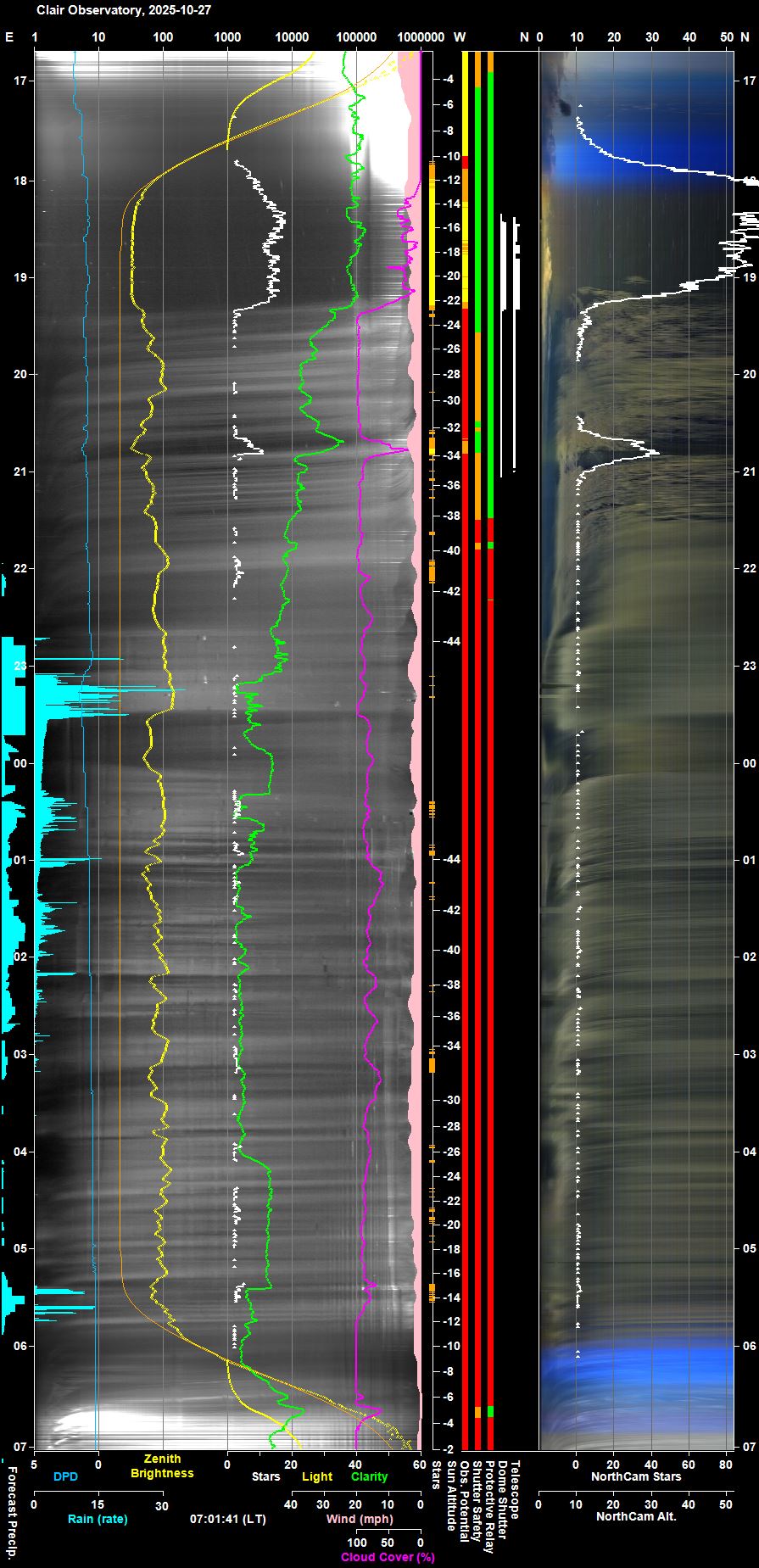

Night Sky Summary Plot
Top axis: Sky Brightness at Zenith (in ADU/s)
Lefthand axis: Local Time (hh LT). Righthand axis: Sun Altitude (degs)
Note:  The NorthCam Star Count line is unreliable and should be ignored
(The AstroNorthCam 'Find' Star method is producing many false positives from clouds)

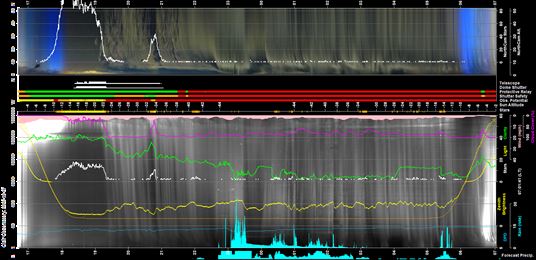

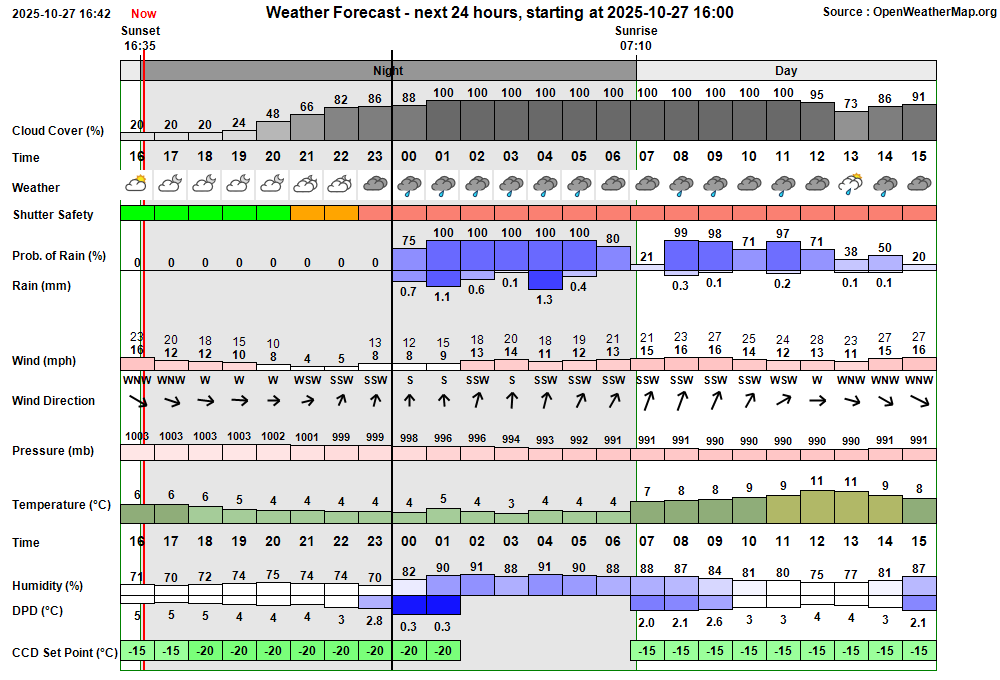

Actual Weather vs Pre-Session Weather Forecast

Session Event Log
Time     Event Detail
17:11:28 Session Monitoring AutoStart monitoring for Live Session opportunity between 17:12 & 05:22
17:11:33   AutoStart Waiting AutoStart waiting till earliest start time at 17:12
17:12:18   AutoStart Delayed Session delayed due to too few stars
18:21:02 Session AutoStarting Session autostarting (18:21)
18:21:15   CCDSoft Restarting CCDSoft being restarted (to set AutoSave No.)
18:21:29 Session Created Session Created (Live, 2025-10-27 S01370, ImageSaveNum: 1370001)
18:21:36   Scope Switched On Telescope Power has been switched on via UPB Switch
18:23:23   Services Started Observatory Services started
18:23:34 Observatory (Auto) Observatory placed in Fully-Automated Mode
18:23:36   AutoStart Delayed Session delayed due to too few stars
18:23:38 Session Pending Session pending (2025-10-27)
18:23:40 Session Initiating Session initiating (2025-10-27)
18:24:00   Camera1 Connected SBIG Camera connected (Set point -20°C)
18:24:07   Plan Requested Observing Plan requested from AstroPlan (1.43.14)
18:24:55   Plan Loaded Observing Plan loaded to queue (Plan ID: 1157)
18:25:39   Telescope Connected Telescope connected (TheSky6)
18:26:03 Session Equilibration Session ready to Open Dome
18:26:48   Dome Opened Dome opened (Opening time 45s, Zigbee 41s)
18:27:09 Session Running Session running
18:27:12   Queue Started Observing Queue started (38 targets selected)
18:27:15     Target Started (NrZen) Target started (Focus Field 21, HIP 103850)
18:27:29       Dome Unparked Dome unparked
18:29:48       Focusing Started-Foc1 Foc1 Focusing Started (TCF-S)
18:32:29       Focusing Completed Foc1 AutoFocus Completed (Profile No 1, wide)
18:34:35       Focusing Completed Foc1 AutoFocus Completed (Profile No 1)
18:34:56       Focusing Started-Foc2 Foc2 Focusing Started (Secondary Scope, using ShCap)
18:36:33       Focusing Completed Foc2 AutoFocus Completed (Profile No 2, wide)
18:38:08       Focusing Completed Foc2 AutoFocus Completed (Profile No 2)
18:38:28     Target Completed (NrZen) Target completed (Focus Field 21, HIP 103850)
18:40:35     Target Started (1/38) Target started (1/38, 2MFGC 13744 w/SN2024afyu)
18:44:57       Focusing Skipped Foc1 focusing skipped - star is too dim (TCF-LSI)
18:45:01     Target Aborted (1/38) Target aborted (1/38, 2MFGC 13744 w/SN2024afyu) due to Priority 1 ToO Target
18:45:05     Target Started (2/39) Target started (2/39, C/2025 A6 (Lemmon), ToO)
19:08:06     Target Aborted (2/39) Target aborted (2/39, C/2025 A6 (Lemmon), ToO) due to User Intervention
19:08:10     Target Started (3/39) Target started (3/39, Nova Ser 2025)
19:18:31     Target Completed Target completed (3/39, Nova Ser 2025)
19:18:36     Target Started (4/39) Target started (4/39, AT2025md (CV))
19:20:06       SoftSuspend Called Soft Suspend called due to Deteriorating Conditions (too few stars)
19:20:17   Critical Cloud Alert Critical Cloud Alert (Obs.Manager will close the Dome)
19:20:19   HardSuspend Called Hard Suspend called due to Critical Conditions (cloud)
19:20:21     Target Aborted (4/39) Target aborted (4/39, AT2025md (CV)) due to cloud
19:20:23   Queue Paused Queue paused for Session Suspension
19:20:25 Session Suspending Session suspending
19:21:11   Dome Closed Dome closed (Closing time 50s, Zigbee 44s)
19:21:14 Session Suspended Session suspended
19:26:31     Target Cancelled Target cancelled (4/39, AT2025md (CV)) due to cloud
19:41:03     Target Cancelled Target cancelled (5/39, C/2024 E1 (Wierzchos)) due to cloud
19:52:29     Target Cancelled Target cancelled (6/39, T CrB) due to cloud
20:12:19     Target Cancelled Target cancelled (7/39, UGC 10058 w/SN2025gvs) due to cloud
20:34:39     Target Cancelled Target cancelled (8/39, SN 2025taz) due to cloud
20:46:57     Target Cancelled Target cancelled (9/39, GCVS BL Lac) due to too few stars
20:56:19     Target Cancelled Target cancelled (10/39, WDS GRB 34) due to cloud
20:58:09 User Intervention User request to close and finish session
20:58:12   Queue Aborted Job Queue aborted
20:58:14 Session Closing Session closing
20:58:19   Dome Closed Dome already closed (closed at 19:21, closing time 50s, zigbee 44s)
20:59:48   Dome Parked Dome parked (parking time 80s), Az: 90.0 deg
21:00:35   Telescope Parked Telescope parked (parking time 43s total)
21:00:59   Telescope State Handbox reads 'Scope parked Turn scope off.'
21:01:21   Telescope Switched Off Telescope Power has been switched off via UPB Switch.
21:02:47   Services Stopped Night Services stopped
21:02:49 Session Finishing Session Finishing started (Create Fits Summary, Transfer Files)
21:02:57     Dome (Find Park) Find Park started (Search Az 88.0 to 92.0°, Step 0.2°, Narrow)
21:03:41     Dome Find Park found (Best Park Az 90.2°)
21:03:47     Dome Dome has been synced at park position (Az 90.0°, Adjustment: -0.2°)
21:03:49   Dome Parked Dome parked
21:03:55   Dome Charging Dome is parked and re-charging Ok (18mA)
21:03:57 Session Finished Session Finished

Session Alerts & Alarms
Time     Type       Name Detail
21:03:55 Green Clear Dome Charging Dome is parked and re-charging Ok (18mA)

Back to Top

Operational Issues (2025-10-27 S1370)

[ Prev | Next ]

Critical Issues

Major Issues

Minor Issues

Small Defects

Continuous Improvement

[ Prev | Next ]

Back to Top Issue,  Back to Top

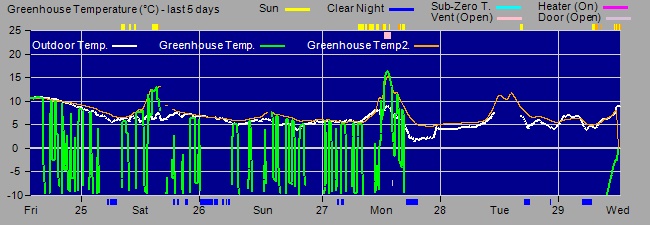

Fig 1.  Greenhouse Temperatures showing issue with Greenhouse1 Temperature (green line) even before it finally stopped working at 2025-10-27 18:10

During at least last 3 days the Greenhouse Temperature sensor 1 has intermittently being giving values of -100. The zigbee network finally lost connection to the sensor at 2025-10-27 18:11 when battery levels had fallen to 8% or less.

[ Prev | Next ]

Back to Top Issue,  Back to Top

2025-10-28

AllSky/Weather Computer - Upgrade to Windows 11

Introduction

The AllSky/Weather Computer (a Toshiba Dynabook Satellite Pro C50-E-102, Windows 10) has been operating since 2025-10-23, when it was purchased and setup to replace an earlier computer that had failed (see Replacement AllSky Computer (2020-08-23)

The computer is still running Windows 10 as of 2025-10-27, but this is no longer supported by Microsoft as of 2025-10-14. It is planned to upgrade the computer to Windows 11 to maintain security protection etc.  A PC Health Check already confirms that the computer meets Windows 11 requirements.

The upgrade to Windows 11 will be performed using Windows Update, and as an in-place upgrade:
- data files in C/Data folder and applications/data files in C:/More Programs should be preserved.
- applications and windows settings should be preserved provided that the  "keep personal files and apps" option is chosen during the in-place upgrade process.
  (in the event Windows Update automatically assumes that personal files and apps are to be kept and the option to do otherwise is not given)
- as always it is recommended to back up your data before starting the update/upgrade.
- programs, settings and communications with Observatory Computer, Remote Computers &Observatory Website will need thorough checking post-upgrade.

Windows 11 has been used on the current Development/Analysis Computer since Feb 2023 (see New Development Computer, 2023) where ExplorerPatcher is used to give a traditional styled task bar & start menu position and will need to be installed on the AllSky/Weather Computer after the Windows upgrade. AllSky/Weather Observatory Software has been confirmed to run ok on Development Computer (though not necessarily within live environment) .

The whole process should be done within a day if there are no issues, but if there are issues then 3-4 days of work may be needed to reinstall software & drivers, and perform more extensive testing.  Any lessons will be passed onto upgrade of Observatory Computer to Windows 11.

Applications

Windows

- Admin and User Account
- View
- Desktop Picture, Desktop DPI, Icons Sizes
- Taskbar Toolbars:  Astro, Comp, Apps
- Control Panel
- Device Manager
- Microsoft Edge,  Google Search Provider.

Core Software
- Kaspersky Internet Security (Firewall & AntiVirus)
- UltraVNC  (for Remote Control)
- Dimension 4 (for Time Sync)
-
WinSCP (for ftp file upload to website)
- ExplorerPatcher (windows GUI)

General Software
- TextPad 4   (for File Editing)
- ACDSee Classic (for Image Viewing)
- PaintShopPro 5 (for Screen Capture / Image editing)
- Visual Studio 2022

Observatory Software
- CCDSoft5
- TheSky6
- Aurora Cloud Sensor III  (3.2)
- CumulusMX
- iSpy64

- ASCOM 7.2
- MeadeGeneric Driver
- Starlight Xpress SXV Plug In.dll  (to CCDSoft Version 5 / Camera Plug-Ins)
- ffmpeg-win32-static
- ffmpeg-win64-static

- AstroLaunch
- AstroAllSky
- AstroWeather
- AstroObsCam
- AstroNorthCam

- Alternate Observatory Role Software
- AstroMain
- AstroPlan
- AstroShpCap

- FV (5.3)
- OptecTCF-Lynx Installer
- Pegasus Unity
- Pegasus Unity Ascom Drivers (Switch, Focuser, Observing Conditions)
- PHD2  (autoguiding)
- SharpCap 3.2

Steps towards upgrading computer

2025-10-27 and 2025-10-28 (am)
- Capture Settings (screenshots etc)
- Backup of key files

Upgrade
Upgrade from Windows 10 to Windows 11 on the AllSky/Weather Computer was successfully made on 2025-10-28 with just a single teething issue.

Issues

Follow-Up 2025-11-01
Reviewing System.Information the WIndows 11 version that was installed on the Observatory Computer on 2025-10-28 was 10.0.22631. Checking online showed that this is Windows 11 23H2 (which was earlier second major update to Windows 11).

It is unclear why the Observatory Computer the following day was instead updated to the latest 10.0.26200 version instead, which is the Windows 11 25H2 version.

Since Windows Update is now offering update to Windows 11 25H2 it has been decided to download and install the option, to keep up with the version used by the Observatory Computer.

Update to Windows 11 25H2 (2025-11-01)
AllSky/Weather Computer was updated to 25H2 on 2025-11-01

Rather than shutdown all applications whilst waiting for the downloading and pre-installing to occur, it was decided to keep AllSky/Weather/Observatory services running and wait until Windows Update presented the 'Restart Computer' now button, before closing the services down.

As anticipated the CCDSoft dll's again went missing during the update, and had to be re-copied into the "C:\Program Files (x86)\Common Files\System" folder from  "C:\Data\Computer\Home Computers\Missing CCDSoft DLLs (from Laptop7)" .

The Development Computer is also noted to be on Window 11 23H2 (from time of its original purchase in Feb 2023) and likewise should be updated to Window 11 25H2 version (see Development/Analysis Computer - Windows 11 Update (25H2 Version) ).

Issues

Back to Top Issue,  Back to Top
